Apartment Renovation Timeline: How Long Does It Really Take? 8 Essential Stages Week by Week

Apartment Renovation Timeline: How Long Does It Really Take? 8 Essential Stages Week by Week
Apartment renovation timeline — 8 stages week by week

An apartment renovation timeline is one of the most poorly planned parts of any project. “We’ll finish in two months” often turns into four, while the owner keeps paying rent or double costs. Knowing the real timeline helps you plan your move, budget and contractor schedule correctly.

In this article we show, stage by stage and week by week, how long an apartment renovation takes in Georgia — from black frame to keys — and where the most time is lost.

Short answer: the average apartment renovation timeline for a 60–80 m² apartment in 2026 is: black frame — 3–4 months, green frame — 2–3 months, white frame — 6–9 weeks, cosmetic renovation — 2–4 weeks.

Apartment renovation timeline by condition

Apartment condition 60–80 m² apartment What determines the timeline
Black frame 12–16 weeks Partitions, plastering, screed drying
Green frame 8–12 weeks Heating, plumbing, finishing
White frame 6–9 weeks Putty, painting, flooring, bathroom
Cosmetic renovation 2–4 weeks Painting, replacing flooring, details

8 renovation stages week by week (from black frame)

1. Planning and design — 1–3 weeks

Layout, positions of electrical points and plumbing, choice of materials. The more precisely you plan now, the fewer changes later — and changes are what stretch a renovation the most. Use the design calculator to estimate the cost of the project.

2. Partitions and rough work — 1–2 weeks

Block or drywall partitions, door openings and, if needed, demolition.

3. Electrical and plumbing installation — 1–2 weeks

Cables, socket positions, water and sewage pipes. This is “hidden” work: redoing it later is very expensive and time-consuming.

4. Wall plastering — 1–2 weeks + drying

After plastering, walls need time to dry. In winter, without heating, this process slows down noticeably.

5. Floor screed — 1 week + 3–4 weeks of drying

This is the stage where time is lost most often. A cement screed must dry fully before flooring is laid. If you install laminate or parquet on a damp screed, it will warp. Other work can be done in parallel during this time.

6. Heating system — 1 week

Installation of the boiler, radiators or underfloor heating. Underfloor heating is installed before the screed.

7. Finishing: tiles, putty, painting, ceilings — 3–5 weeks

Bathroom and kitchen tiles, wall putty and paint, stretch or drywall ceilings. This is the most “visible” and labor-intensive stage.

8. Flooring, doors and final touches — 1–2 weeks

Laminate or parquet, interior doors, lights, sockets, sanitary fixtures and final cleaning.

Where time is lost: 5 main reasons

  1. Changes during the work — “let’s move this wall” can cost you two weeks.
  2. Material delays — made-to-order tiles or doors often take 3–6 weeks. Order in advance.
  3. Contractor schedules — when one crew works on several sites, your renovation stops.
  4. Ignoring drying times — rushing here comes back later as cracks and warping.
  5. Funding gaps — if the budget isn’t calculated in advance, work stops halfway.
Tip: write the completion date of each stage into the contract and tie payments to completed stages. This gives the contractor a real incentive to respect the renovation timeline.

Renovation timeline by stage: a visual schedule

When the renovation timeline is broken into stages, it is much easier to see where time is lost and which jobs can be sped up. Below is a typical schedule for a 60 m² apartment from black frame, week by week. The drying pauses are included, because they take up a large share of the time.

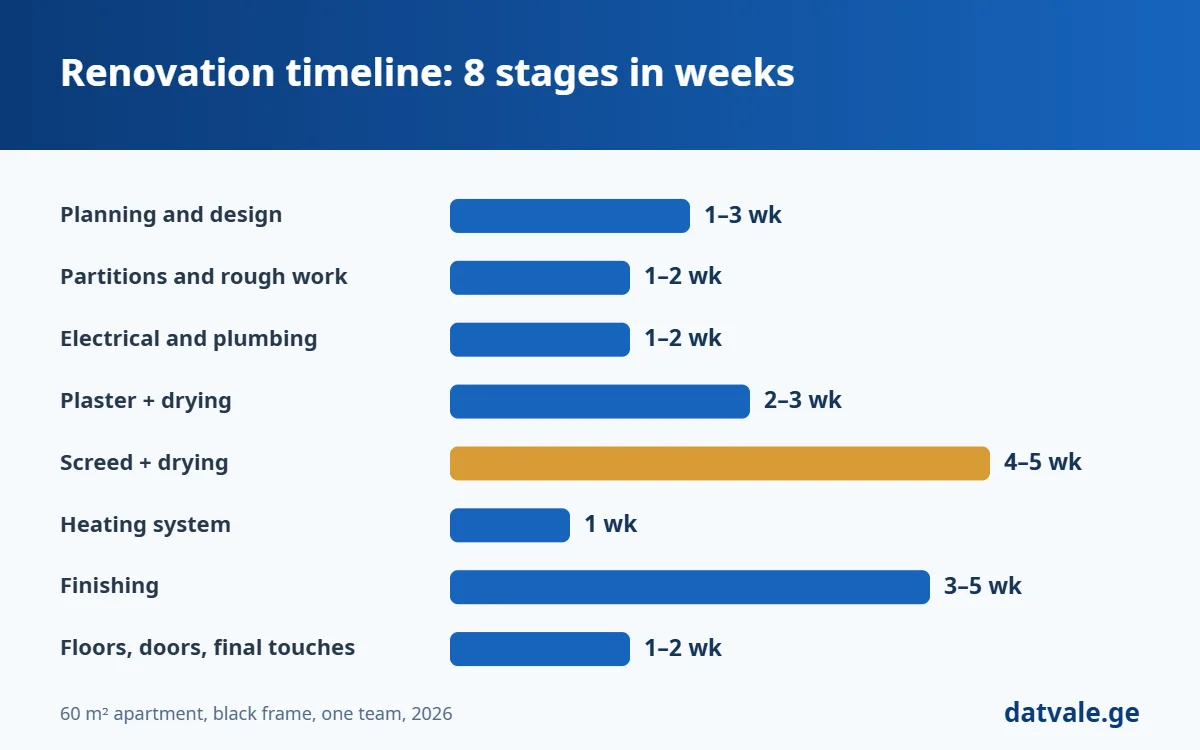

Apartment renovation timeline by stage: 60 m² from black frame

The longest stage is finishing, but the most “deceptive” one is the floor screed. The work itself takes a few days, but full drying needs 3–4 weeks. If you use that time well, for example by plastering walls or working on ceilings, the overall renovation timeline shrinks considerably.

Renovation timeline by apartment condition

Your renovation timeline depends first of all on the condition in which you receive the apartment. The more work there is, the more technological pauses are needed. The figures below apply to a 60 m² apartment, one team and standard-class materials.

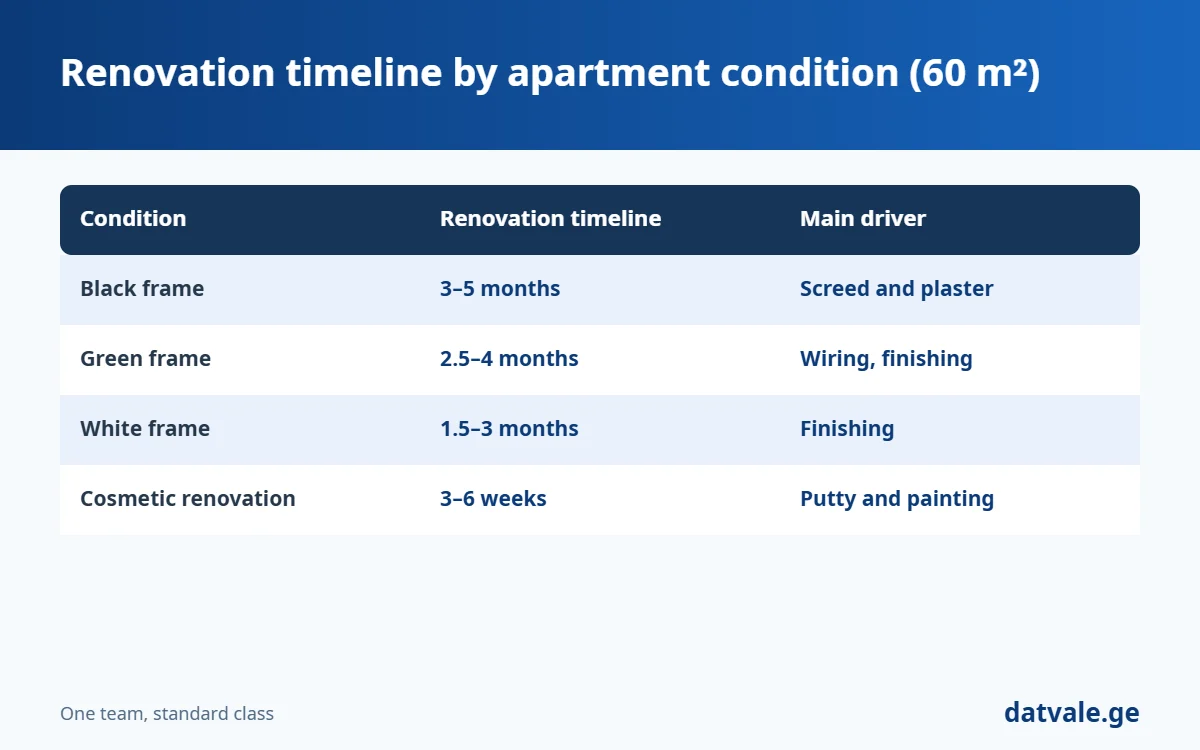

Renovation timeline by apartment condition: black, green and white frame

These timelines assume materials are ordered on time and trades hand over to each other smoothly. In practice, a renovation timeline often grows by 20–30% because of organizational reasons rather than the difficulty of the work itself.

Technological pauses: why you cannot rush drying

The most dangerous way to shorten a renovation timeline is to cut drying time. Materials have physical limits, and if you ignore them you get cracks, swollen laminate or falling tiles. Here are indicative drying times for the main materials:

Material / job Indicative drying time
Cement screed (5 cm) 3–4 weeks
Self-leveling compound 3–7 days
Gypsum plaster 7–10 days
A coat of putty 12–24 hours
Tile adhesive 24–48 hours before grouting
Waterproofing 24–48 hours
Water-based paint 2–4 hours between coats

Note that these times vary with temperature and humidity. In winter, in an unheated apartment or in high humidity, drying can take twice as long. That is why a winter renovation timeline should always be planned more carefully.

How to check whether the screed is dry

The simplest old trick: lay a 1×1 m piece of plastic film on the screed and tape down the edges. If condensation or a damp patch appears under the film after 24 hours, the screed is still wet and it is too early to lay laminate or parquet. Professionals use a moisture meter for this.

Material lead times: the hidden reason renovations stall

Many people think the renovation timeline depends only on how fast the contractors work. In reality, work very often stops because a material or item has not arrived yet. Some items have lead times of several weeks:

  • Made-to-order interior doors: 3–6 weeks.
  • Kitchen furniture: 4–8 weeks from measuring to installation.
  • Windows and balcony door: 2–4 weeks.
  • Imported tiles or plumbing: 2–6 weeks if not in stock.
  • Stretch ceiling: about 1 week from measuring.
  • Built-in wardrobes: 3–5 weeks.

So order these items at the start of the renovation, not when the contractor tells you “we need the doors tomorrow”. Some can only be measured at a specific stage, for instance the final size of a door opening is known only after plastering, so put the measuring date into your schedule in advance.

How to build a renovation timeline step by step

A realistic schedule is just as important as the renovation budget. A well-made renovation timeline helps you order materials on time, call trades in the right order and know when you can move in.

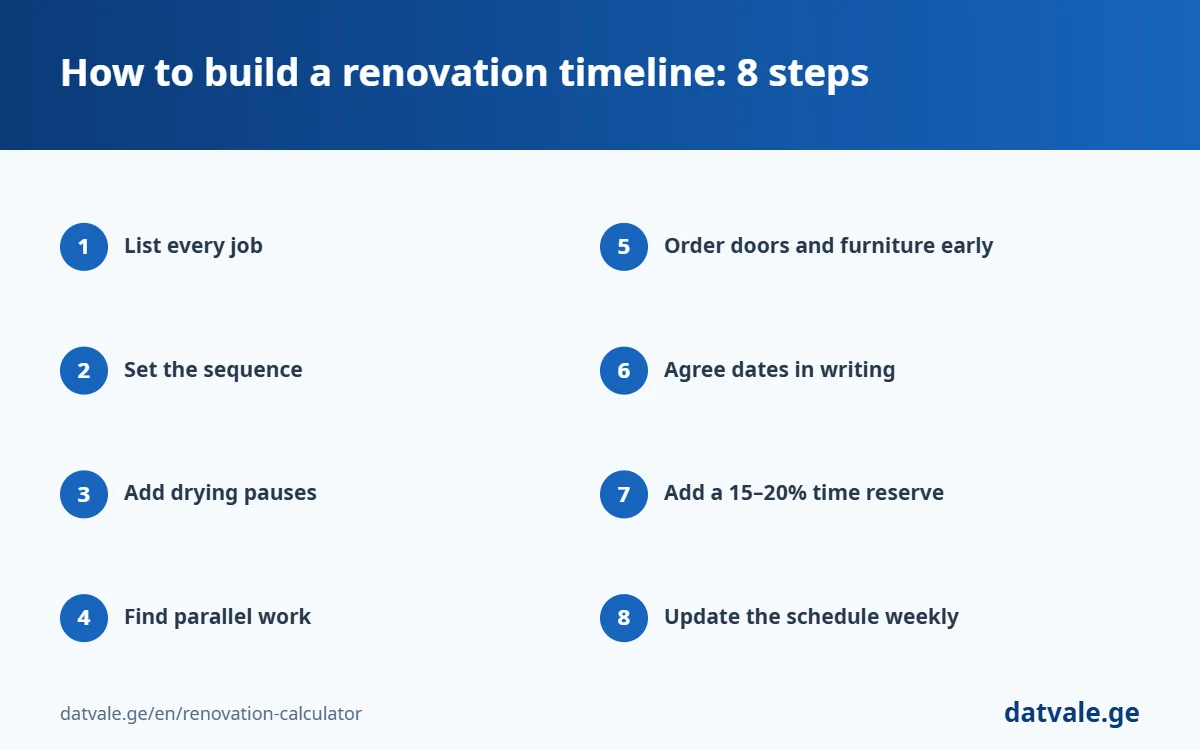

How to build a renovation timeline in 8 steps
  1. List every job: by room and by stage.
  2. Set the sequence: “wet” and hidden work first, then finishing.
  3. Add drying pauses: screed, plaster and waterproofing.
  4. Find parallel work: what can be done at the same time in different rooms.
  5. Order long-lead items: doors, kitchen and windows.
  6. Agree dates with contractors: in writing, for every stage.
  7. Add a 15–20% time reserve: for unexpected delays.
  8. Update the schedule weekly: and spot delays early.

Parallel work: how to cut the renovation timeline by 2–3 weeks

The most effective way to shorten a renovation timeline is to distribute the work correctly. While the screed dries in one room, plastering can go on in another. While putty dries on the walls, tiles can be laid in the bathroom.

  • While the screed dries: ceiling work, wall plastering and putty.
  • Between coats of putty: bathroom tiles and the kitchen backsplash.
  • While paint dries: installing sockets and switches, connecting plumbing.
  • Alongside laminate laying: preparing for kitchen furniture assembly.

One condition: parallel work requires good coordination. Dusty work such as sanding putty must not coincide with painting in the same space. So someone, whether you, a foreman or a supervisor, must be responsible for the whole renovation timeline.

Renovation timeline by room

If you are not doing a full renovation and only need to update one or two rooms, room-by-room timelines are more useful than an overall schedule. Here are indicative times for individual spaces when the hidden work is already done:

  • Bathroom (4–6 m²): 2–3 weeks. Removing old tiles, waterproofing, tiling, grouting and installing plumbing. Drying of waterproofing and adhesive takes most of the time here.
  • Kitchen: 1.5–2 weeks of construction work, plus the furniture lead time, often 4–8 weeks.
  • Bedroom or living room (15–20 m²): 1–2 weeks: putty, painting, flooring and lighting.
  • Hallway: 1 week, but usually done last because it gets damaged most while materials are carried in.
  • Balcony or loggia: 1–2 weeks, depending on finishing and glazing.

If you live in the apartment and renovate in stages, start with the bathroom or kitchen: these are the most complex and noisiest jobs. You can then update the living rooms one by one without having to move out.

Season and renovation timeline: when is the best time to start?

Weather directly affects your renovation timeline. In summer, plaster and screed dry faster, but on very hot days the surface dries too quickly and can crack, so it needs to be dampened. In winter, if the apartment has no heating yet, drying slows down 1.5–2 times, and some mixes cannot be used below +5°C at all.

The ideal time to start “wet” work is spring and early autumn. If you start in winter, install the heating system or temporary heaters first. This will cut the renovation timeline by several weeks and protect quality.

Holidays and vacations

When planning, take into account the New Year and Easter periods, as well as August, when many contractors and stores are on vacation or working reduced hours. These one or two weeks often become the biggest “invisible” loss in a renovation timeline.

A real example: renovation timeline for a 60 m² apartment

Take a real case: a 60 m² two-bedroom apartment in Didube, from black frame, standard class. The renovation started in early March. Planning and design took 2 weeks, then partitions and electrical and plumbing installation took 3 weeks. Plastering and screed started in week 6; while the screed dried, the team worked on ceilings and bathroom waterproofing.

Finishing (tiles, putty and painting) took 5 weeks, and flooring, doors and final touches took 2 weeks. The kitchen furniture was ordered early, in week 4, so it arrived exactly on time. The result was a renovation timeline of 16 weeks, about 4 months, which is a good result for black frame. The family said that ordering early and parallel work saved them the most time.

Renovation timeline in an old apartment

In an old apartment, the renovation timeline is often longer than expected, because demolition alone takes 1–2 weeks: removing old tiles, plaster, flooring and wooden frames, plus waste removal. Then come the “surprises”: damaged pipes, old wiring and uneven walls that need extra plastering.

That is why it is recommended to plan an old-apartment renovation timeline with a 20–30% reserve. A full renovation of a 60 m² apartment in an old building usually takes 3–4.5 months, even if the area and scope are similar to a new build.

Deadlines in the contract: how to protect yourself from delays

A verbal “we’ll finish in two months” is no guarantee. In the contract, or at least in a written agreement, include:

  • start and finish dates for each stage;
  • payments tied to completed stages rather than calendar dates;
  • a penalty or discount for each day of delay if it is the contractor’s fault;
  • what counts as a valid reason, such as late materials on your side or extreme weather;
  • a weekly report with photos of completed work.

Such terms do not scare a contractor away; they create clear rules for both sides. Good contractors usually agree to a realistic renovation timeline when it is drawn up together.

Renovation timeline and budget: time is money

Many owners see the renovation timeline as a matter of patience, but every extra month is a direct cost. If you rent while renovating, a two-month delay can cost 1,200–2,000 GEL. If you plan to rent the apartment out, every month is lost income. If the renovation is financed by a loan, interest is paid every month whether or not the work is finished.

So it is sometimes more profitable to pay a little more for an organized team or supervision if it shortens the renovation timeline by several weeks. Do the math: one month of rent or lost income often exceeds the difference between cheap and mid-priced contractors.

Who should manage the renovation timeline?

  • You: if you have the time, are often on site and are ready to coordinate the trades. The cheapest but most time-consuming option.
  • A foreman: an experienced contractor who manages their own team and subcontractors. A good balance between price and control.
  • A renovation company or technical supervisor: the most expensive, but full responsibility for deadlines and quality is theirs.

The main mistake is when every contractor works for themselves and nobody knows who should come when. The electrician waits for the plasterer, the plasterer waits for the plumber, and the plumber is at another site. A week disappears very quickly that way.

Where you should never rush

  • Bathroom waterproofing: each coat needs to dry fully before tiling. Rushing here risks flooding the neighbors.
  • Screed drying: laminate or parquet laid on damp screed will swell within months.
  • Coats of putty: if the next coat goes on too early, cracks and waves appear on the wall.
  • Grout and silicone: using them too early causes joint discoloration and mold.

The right approach is to shorten the renovation timeline through organization (early orders, parallel work and good coordination), not by breaking the technology.

Summary

A realistic renovation timeline for a 60 m² apartment is 3–5 months from black frame, 1.5–3 months from white frame and 3–6 weeks for a cosmetic renovation. To shorten it, order long-lead items at the start, use drying pauses for parallel work, put dates in the contract and add a 15–20% time reserve. Do not rush drying: a week “saved” that way turns into months of cracks and rework later.

How to shorten your apartment renovation timeline

  • Buy all materials before work starts or order them on time;
  • Plan parallel work: walls can be prepared while the screed dries;
  • Don’t change the project after work has started;
  • Choose a crew that works only on your site;
  • Calculate your budget in advance so work never stops for financial reasons.

Official information on building regulations and permits in Georgia is available on Matsne.

Plan your renovation with a timeline and budget

Calculate renovation costs with materials and labor so work never stops at any stage.

Renovation calculator →

Frequently asked questions

How long does it take to renovate a 60 m² apartment from black frame?

On average 3–4 months, if materials are bought on time and the project doesn’t change during the work.

Which stage takes the longest?

Finishing and screed drying. A screed needs 3–4 weeks before flooring can be laid.

Can I renovate in winter?

Yes, but plaster and screed need heating to dry, otherwise the renovation timeline gets longer.

How can I control a renovation remotely?

Ask for weekly photo and video reports and tie payments to completed stages.

How much can parallel work shorten a renovation timeline?

With good coordination, usually by 2–3 weeks in a 60 m² apartment, especially while the screed and plaster are drying.

When should I order doors and the kitchen?

At the very start of the renovation. Lead times are often 3–8 weeks, so a late order directly extends the renovation timeline.

How soon can I move in after the renovation?

After the final painting and cleaning, it is best to air the apartment well for 3–7 days, especially if children or people with allergies will live there.

Timelines are approximate and depend on the property, season and crew. Updated: October 2026. Follow us on Facebook and YouTube.

×
