Contractor Price Increase? 7 Sneaky Tricks That Inflate Your Renovation Budget (and How to Stop Them)

Contractor Price Increase? 7 Sneaky Tricks That Inflate Your Renovation Budget (and How to Stop Them)
Contractor price increase during apartment renovation

Contractor price increase is one of the most common renovation surprises: the price agreed at the start is often very different from the final bill. If you’ve ever heard “some extra work came up”, you know what we mean. A growing budget isn’t always fraud, but it is often the result of a vague agreement that lets the contractor raise the price.

In this article we cover the 7 most common tricks that inflate renovation costs — and simple ways to protect yourself.

The golden rule: the contractor price must be written, detailed and tied to a specific job — per m², per linear meter or per piece. A verbal “roughly” is the most expensive agreement you can make.

Trick 1: “The price is per m², but preparation is extra”

The contractor quotes a tiling price per m², but later charges separately for leveling walls, primer, waterproofing and cutting tiles. In the end the price can grow by 30–50%.

How to protect yourself: ask in advance what is and isn’t included. Request a list: preparation, main work, finishing.

Trick 2: Inflated material “waste”

A normal reserve is 10% for tiles and 5–7% for laminate. Some contractors ask for 20–25%, and the surplus later “disappears” to another site.

How to protect yourself: calculate quantities yourself with a calculator and compare them with the contractor’s list.

Trick 3: “This material is bad, you need to buy that one”

The contractor recommends a specific store or brand. Sometimes that comes from experience — sometimes from a commission paid by the store.

How to protect yourself: compare prices in 2–3 stores and use Datvale partner discounts.

Trick 4: A daily rate instead of a fixed price

“150 GEL per day” sounds transparent, but the timeline is in the contractor’s hands. Two weeks of work can easily stretch to a month.

How to protect yourself: tie the contractor price to the scope of work, not to time. A daily rate is acceptable only for small jobs that can’t be defined in advance.

Trick 5: “Hidden” problems discovered mid-project

After opening a wall, the contractor says the pipes or wiring must be replaced. Sometimes this is true — sometimes it isn’t.

How to protect yourself: ask for a photo or video of the problem and, if needed, a second specialist’s opinion. Approve extra work only in writing.

Trick 6: A large upfront payment

“I need 70% upfront to buy materials” is one of the riskiest situations. Once paid, the contractor has less motivation to finish on time.

How to protect yourself: pay in stages based on completed work. It’s better to buy materials yourself.

Trick 7: “Materials got more expensive” price hikes

Halfway through the renovation, the contractor says prices went up and labor must cost more too. If the contract doesn’t say so, it’s only their decision.

How to protect yourself: state in the contract that the labor price is fixed for the entire project.

How much does contractor labor cost in 2026?

Knowing market prices is the best protection. Here are approximate labor prices for 2026 in Georgia:

Work Approximate price
Tile installation 35–65 GEL / m²
Laminate installation 8–18 GEL / m²
Parquet installation 15–50 GEL / m²
Stretch ceiling (with installation) 27–45 GEL / m²
Plumbing point 55–180 GEL / piece

For detailed prices, see Renovation labor costs 2026.

Important: contracts with contractors and companies in Georgia are governed by the Civil Code. You can read it on Matsne, the official legislative portal, and for a large project it’s worth having a lawyer review the contract.

Contractor prices by job: an extended 2026 price table

The table above covers the main jobs, but a renovation has many more line items. The more prices you know in advance, the harder it is for anyone to sneak in a contractor price increase. Below are indicative labor prices in Tbilisi for the most common jobs, labor only, without materials.

Contractor price increase guide: 2026 labor rates per job in Georgia

These figures are an average range. The lower end usually applies to simple, large and straight surfaces, and the upper end to complex, small or uneven ones. If a quote is far above this range, ask why. Sometimes the reason is objective, such as large-format tiles or a complex design; sometimes it is simply an attempt to see what you will accept.

Why contractor prices differ: 6 objective factors

Two contractors can quote prices that differ by a factor of two for the same job, and both can be right: a contractor price depends on many things. What matters is understanding what drives the difference, so you can tell a fair quote from a future contractor price increase.

1. Surface condition

Laying tiles on an uneven wall takes far more time and material than on a pre-leveled one. That is why a good contractor always visits the site before quoting. If you get a price over the phone without anyone seeing the apartment, that number will almost certainly change.

2. Volume of work

On a large project, a contractor is willing to quote a lower price per m² because the work is guaranteed for several weeks. On small jobs, such as tiling 3 m², they often charge a minimum fee, which works out very expensive per square meter.

3. Complexity and design

Diagonal laying, mosaics, niches, hidden curtain rails and curved shapes all raise the price by 20–50%. This is normal, but you should know about it in advance, not at the end of the job.

4. Season

Demand peaks in spring and late summer, so good contractors have waiting lists and higher prices. In winter, some jobs, such as interior finishing, can be agreed 10–15% cheaper.

5. Material delivery

Some contractors include buying and delivering materials in their price, others do not. An offer that looks more expensive may actually be cheaper if it also covers transport and waste removal.

6. Experience and warranty

A contractor who offers a warranty and shows you a portfolio is usually more expensive. That extra cost is often far cheaper than redoing badly done work.

How to compare 3 quotes and avoid a contractor price increase

The most common mistake is comparing quotes by the final figure alone. You can only compare contractor prices when all three quotes cover exactly the same work. Here is a real example for tiling a 5 m² bathroom (22 m² of walls and floor):

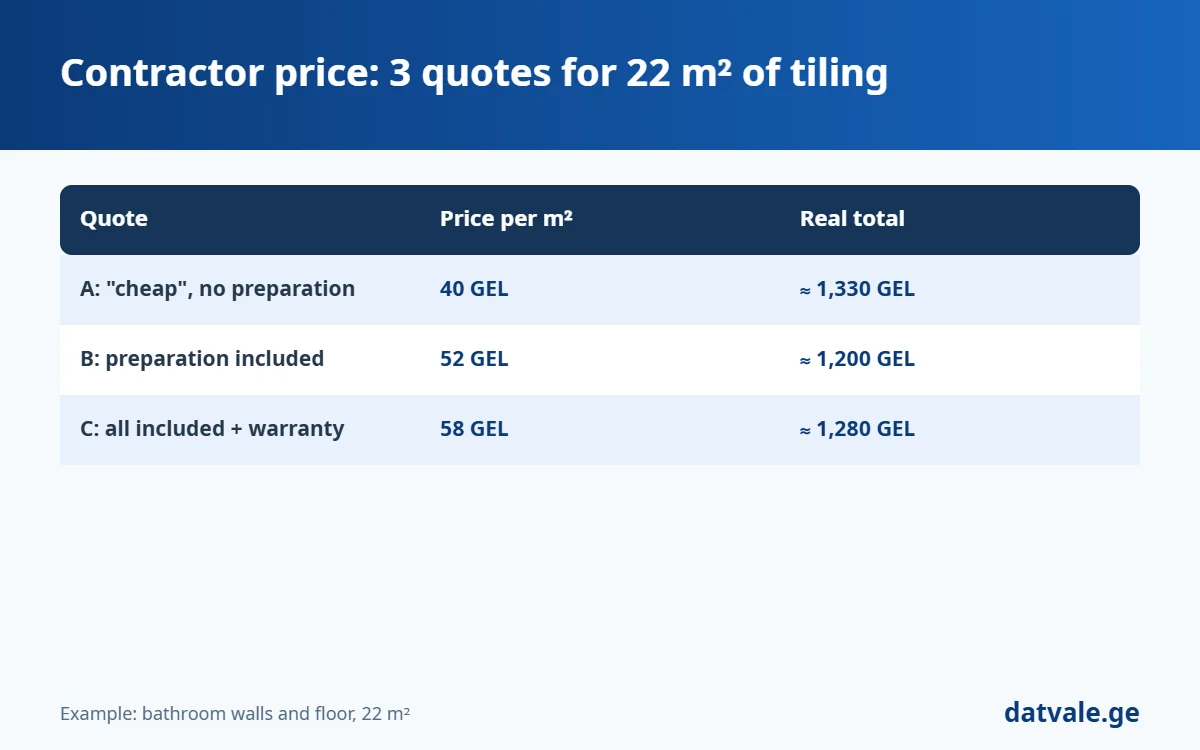

Contractor price increase example: comparing three tiling quotes

As you can see, the “cheapest” offer turned out to be the most expensive in the end, because preparation, waterproofing and grout were not included. This is exactly how trick no. 1 works. So before comparing, give all three contractors the same list of jobs and ask them to price each item separately.

A comparison sheet you should fill in yourself

  • Unit price: per m², linear meter or piece.
  • What is included: preparation, primer, waterproofing, grout and waste removal.
  • Timeline: specific start and finish dates.
  • Payment schedule: how much upfront and how much by stage.
  • Warranty: for how long and on what.

8 red flags that a contractor price increase is coming

Some signals are visible during the negotiation itself. If you notice two or more of the following, a contractor price increase during the project is very likely.

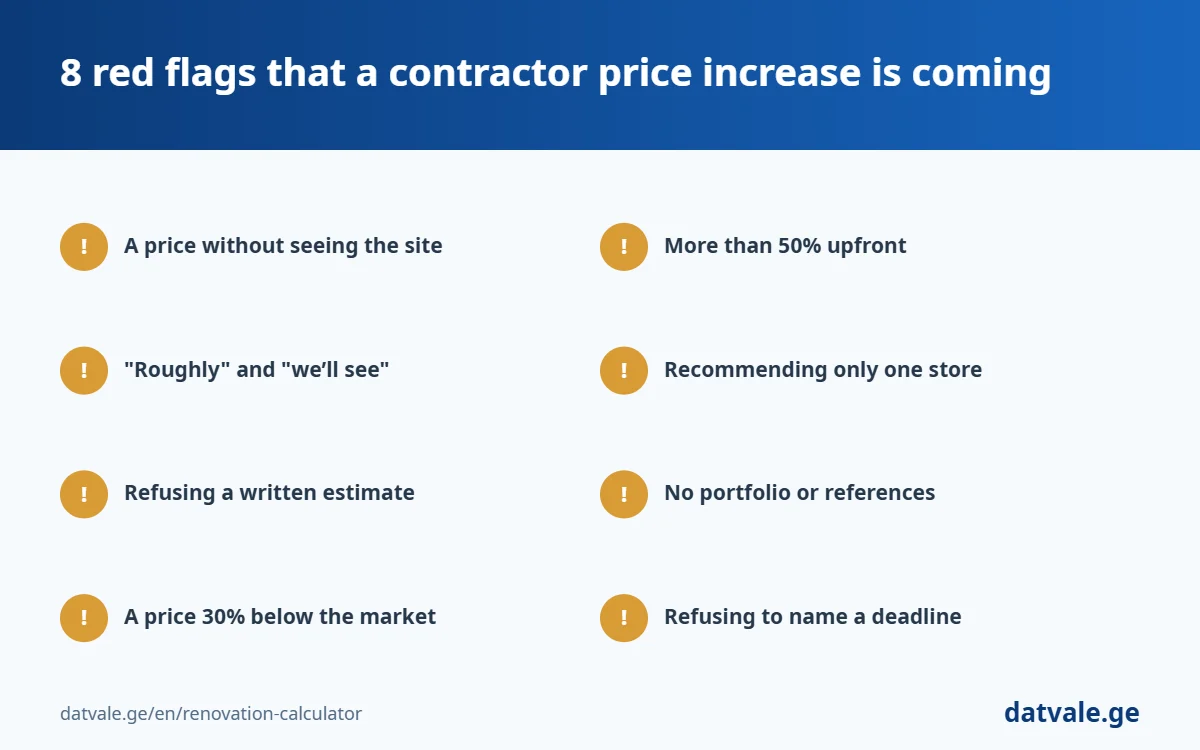

8 red flags of a contractor price increase
  1. A price without seeing the site: a figure given over the phone rarely stays the same.
  2. “Roughly” and “we’ll see”: vague wording is the basis of a future dispute.
  3. Refusing a written estimate: if a contractor avoids putting the price on paper, that is a serious warning sign.
  4. A price 30% below the market: the difference will “come back” somewhere later.
  5. A large upfront payment: asking for more than 50% before work starts.
  6. Recommending only one store: and refusing to work with materials bought elsewhere.
  7. No portfolio or references: they cannot show you previous work.
  8. Refusing to name a deadline: “when I’m done” is not a deadline.

What your contract with a contractor should include

A contract does not need to be long or complicated. One or two pages where the price and terms are clearly set out are enough. At a minimum, it should include:

  • The parties: names, ID number or company details and contact information.
  • A list of jobs: with quantities and unit prices.
  • The total amount: and a clause stating that the labor price is fixed for the whole project.
  • Deadlines: start, stage and completion dates.
  • A payment schedule: by stage, after each stage is accepted.
  • Additional work: only by written agreement, with the price fixed in advance.
  • Warranty: for example, 12 months on completed work.
  • Delays: a penalty or discount for each day of delay.

Even a simple written agreement is far better than a verbal one. An estimate sent and confirmed in a messenger app is important evidence if there is ever a dispute about a contractor price increase.

An individual contractor or a renovation company?

An individual contractor is usually 15–25% cheaper than a renovation company. On the other hand, a company often coordinates all the trades itself, controls deadlines, gives an official warranty and signs a formal contract.

For a small job, such as one bathroom or repainting, an individual contractor is completely sufficient. For a full renovation from black or white frame when you cannot be on site often, a company or a technical supervisor often pays for itself, because one contractor’s delay holds up every stage that follows.

A real example: how a contractor price increase reached 50%

In Saburtalo, Tbilisi, an apartment owner verbally agreed on 40 GEL per m² for bathroom tiling. For 22 m² of walls and floor, that should have been 880 GEL. After work started, the contractor added wall leveling (180 GEL), waterproofing (120 GEL), 45-degree tile cutting at the corners (90 GEL) and grout (60 GEL). In the end, the price became 1,330 GEL, about 50% more.

Formally, the contractor was not lying: all of this work really was needed. The problem was that it was never clear from the start what the 40 GEL included. If the agreement had been written and detailed, the owner would either have chosen another offer or at least planned the budget in advance.

When is a contractor price increase fair?

Not every price increase is a trick. There are situations where a contractor price increase is justified, and arguing about it will only damage the relationship. The key is to tell these situations apart from tricks.

  • You changed the plan. If you decide to change the tile format, add sockets or a niche after work has started, extra payment is logical.
  • A real, documented problem was found. For example, an old damaged pipe that is visible in a photo and confirmed by a second specialist.
  • You chose a material that is hard to install. Large-format porcelain or natural stone takes much more time.
  • The timeline slipped because of you. If you did not deliver materials on time and the contractor had to wait, their claim is understandable.

In all of these cases, one rule applies: any new price must be agreed in advance and in writing, before the work is done, including any new contractor price. If a contractor does the work first and tells you the price afterwards, that is already a problem.

10 questions to ask before agreeing on a contractor price

  1. What is included in the price and what is not?
  2. Is the price fixed or can it change? In what cases?
  3. Who buys the materials and who pays for delivery?
  4. Who removes construction waste, and is it included in the price?
  5. When will you start and when will you finish?
  6. How many people will work on site?
  7. What payment schedule do you propose?
  8. What warranty do you give and for how long?
  9. Can you show me previous work or put me in touch with a past client?
  10. What happens if you miss the deadline?

If a contractor answers these questions calmly and specifically, that is a good sign. If they get irritated or avoid answering, think twice about working with them, however attractive the contractor price may be.

How to find a reliable contractor at a fair price

Finding a good contractor is often harder than choosing materials. The best source is still a recommendation: friends, relatives or neighbors who recently finished a renovation. That way you can see the finished work with your own eyes and ask whether there was a contractor price increase along the way.

Be more careful with contractors found on social media and classified sites: ask for photos of real projects, not just pictures from the internet, and ideally visit one of their previous sites in person. On Datvale‘s partners page you can also find verified companies and stores.

A small first job is the best test

If you do not know a contractor, start with a small, clearly defined job, such as plastering one room or tiling the bathroom floor. You will see their quality, punctuality and whether they stick to the agreed contractor price. If all goes well, you can move on to the larger job.

Contractor price and material quality: where the real savings are

Many owners try to push the contractor price as low as possible while not saving on materials. In practice, the opposite is often better. Expensive tiles look worse in the hands of a bad contractor than mid-range tiles in the hands of a good one. Installation quality, meaning straight joints, an even surface and precise corner cuts, is what you see every day.

So if your budget is limited, negotiate less on labor and save on materials instead: choose mid-range tiles with accurate geometry, compare prices across several stores and use partner discounts. The end result will be better than with expensive materials and cheap labor.

When a more expensive contractor is worth it

  • Large-format tiles: 60×120 cm and larger require special experience and tools.
  • Bathroom waterproofing: mistakes here end with a flooded neighbor and tiles being ripped out.
  • Electrical wiring: this is a safety issue and no place for savings.
  • The heating system: a badly installed boiler or radiators will bother you all winter.

Photo and video reports: simple protection from a distance

If you cannot visit the site often, agree with the contractor that they will send a few photos or a short video at the end of each working day. This is not a sign of distrust; it is normal professional practice that good contractors are happy to accept. Photos show you how much work was really done, and if the contractor later reports a “hidden problem”, you have visual material to check whether it really existed and whether the contractor price increase is fair.

Be sure to photograph pipes and wiring before the walls are closed (with a tape measure in the frame), bathroom waterproofing before tiling, the floor screed and the walls after putty. This photo archive will also be valuable after the renovation, when you need to drill a hole or add a socket.

In short: 5 rules for a fair price

  1. Check market prices and calculate the job with a calculator before you contact a contractor.
  2. Get at least three quotes based on the same list of jobs.
  3. Put the agreement in writing, with unit prices and a fixed total.
  4. Pay by stage and only after checking the completed work.
  5. Agree every additional job and any new price in advance, before the work starts.

These five rules need no special knowledge or much time, but in practice they are what separates a renovation that finishes within budget from one that turns into surprise costs and disputes.

Quick checklist: how to agree on a contractor price

  • A written estimate for each job;
  • Clearly defined: what is and isn’t included in the price;
  • Start and completion dates;
  • Staged payments based on completed work;
  • Extra work only with written approval;
  • Warranty terms for completed work.

Know the price before the contractor tells you

Calculate materials and labor in advance — you’ll spot any overcharge immediately.

Renovation calculator →

Frequently asked questions

How much can a contractor price increase during a renovation?

On a well-planned project, the increase should not exceed 10%. A 20–30% increase is usually the result of a vague agreement.

Is a fixed price better than a daily rate?

In most cases a fixed price for the scope of work is safer, because the risk of delays shifts to the contractor.

How much should I pay upfront?

Usually 10–30%, with the rest in stages. It’s better to buy materials yourself.

How can I check if a contractor price is fair?

Ask for 2–3 quotes for the same job and compare them with the result of the Datvale calculator.

What is usually included in a contractor price?

The main job per unit. Preparation, waterproofing, grout, material delivery and waste removal are often extra, so always confirm in writing.

Can I negotiate a contractor price?

Yes, especially on a large project or in winter. But a very low price is often achieved at the expense of quality or the timeline.

What should I do if a contractor abandons the job halfway?

Stop payments, document the completed work with photos and, under your agreement, ask for any overpayment back. For large sums, consult a lawyer.
